Back Mission phases and project lifecycle

Mission phases and project lifecycle


Date: 05 November 2017
Copyright: ESA

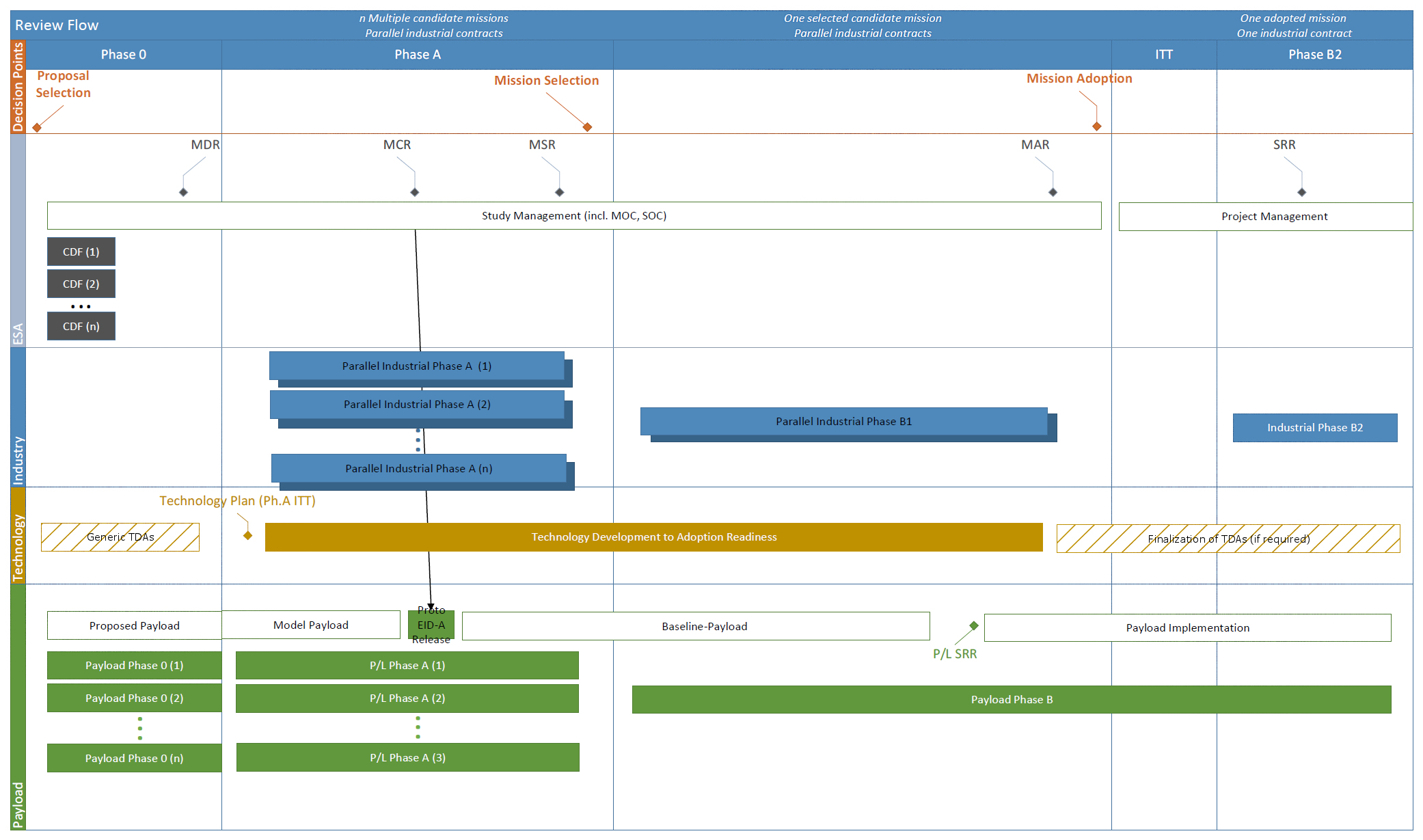

This figure indicates the phases and project lifecycle of missions in ESA's Science Programme, from Phase 0 through to mission adoption.

Acronyms used in this figure:

CDF : Concurrent Design Facility
MDR : Mission Definition Review
MCR : Mission Consolidation Review
MSR : Mission Selection Review
MAR : Mission Adoption Review
SRR : System Requirements Review
ITT : Invitation to Tender
TDA : Technology Development Activity
EID-A : Experiment Interface Requirements Document – Part A
P/L : Payload
